TRM

Case study: cost-cutting prioritization

In 2023 our engineering and IT department needed to bring vendor costs down 20%. How do you pick the right cuts? If we looked only at cost, we could leave the company crippled. We needed a way to weigh the price we’d pay against the benefit we were after. Enter the TRM analysis.

Here are three of the choices, ranked by how many dollars each returned for every dollar it gave up. Figures marked illustrative were chosen for the example, not recalled.

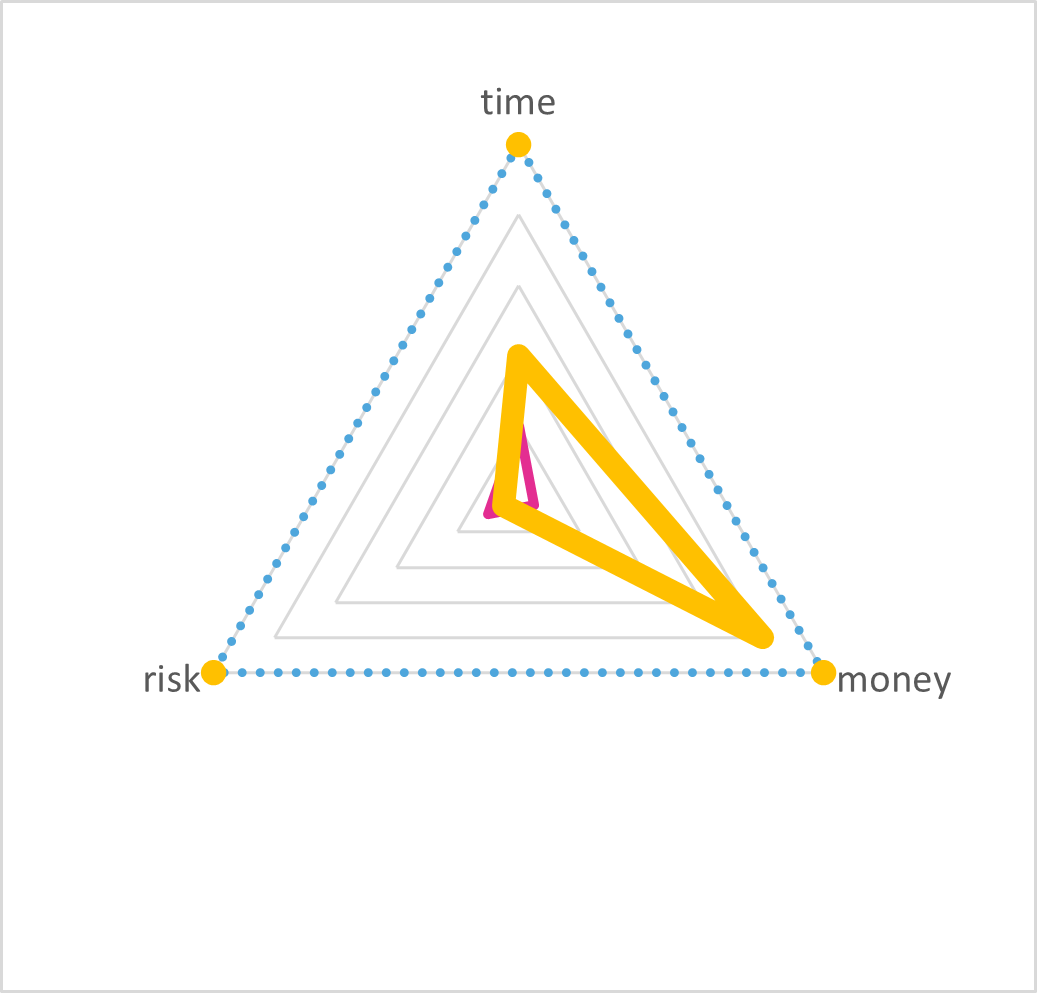

  1. UAT environment removed168×net +$200,800payback month 1Given uptime −$1.2k (given up)$1,200Gainedtime +$52k (gained)time +$52kmoney +$150k (gained)money +$150k$202,000time +$50,800 · money +$150,000 · risk $0
    UAT environment removed: the numbers behind the chart, over 12 months
    ItemPillarSideDollars
    Effort to remove ittimegiven up$1,200
    AWS for the UAT environmentmoneygained$150,000
    Developer time no longer spent on UATtimegained$52,000
    Multiple168×
    Gained$202,000
    Given up$1,200
    Net+$200,800
    Paybackpayback month 1
    Net time+$50,800
    Net money+$150,000
    Net risk$0

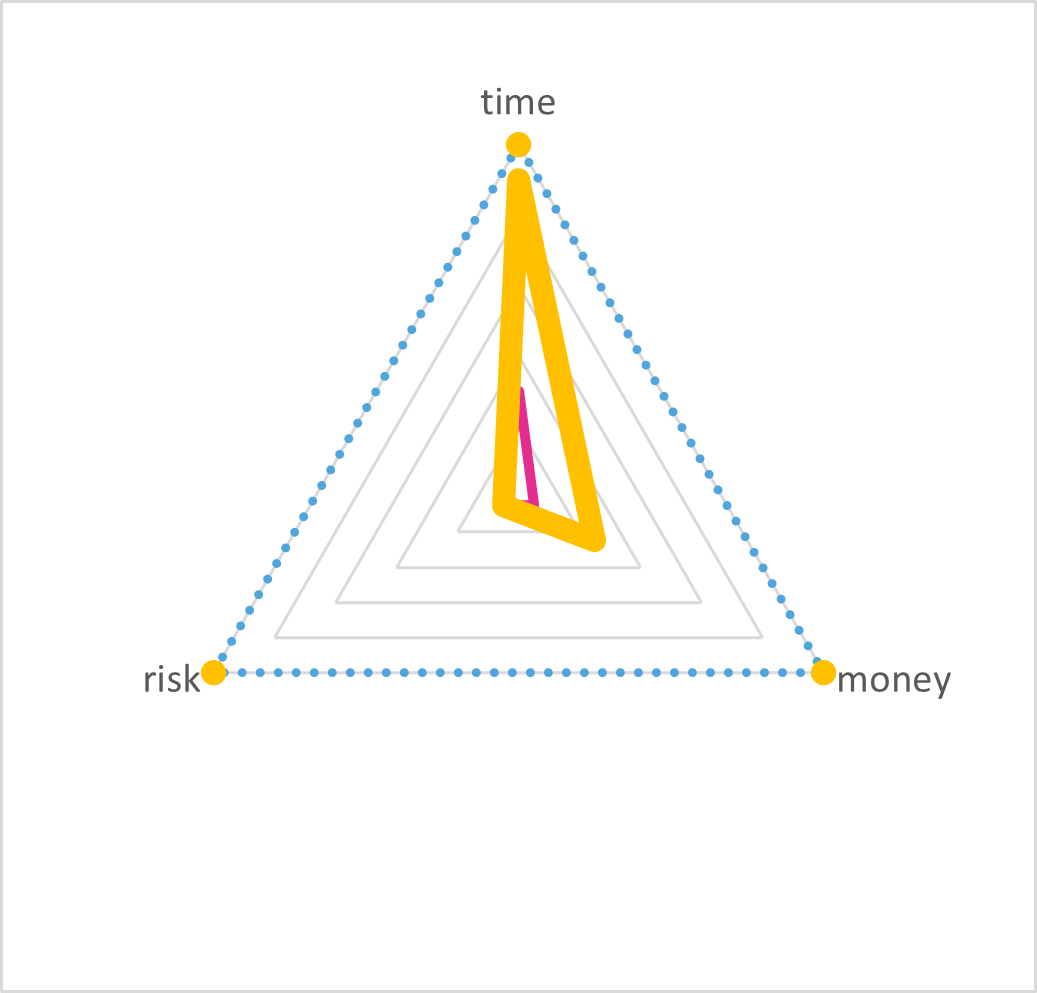

  2. Data-store provisioning automated26×net +$100,000payback month 1illustrative figuresGiven uptime −$4k (given up)$4,000Gainedtime +$104k (gained)time +$104k$104,000time +$100,000 · money $0 · risk $0
    Data-store provisioning automated: the numbers behind the chart, over 12 months
    ItemPillarSideDollars
    Build the automationtimegiven up$4,000
    Two weeks of waiting removed (illustrative)timegained$104,000
    Multiple26×
    Gained$104,000
    Given up$4,000
    Net+$100,000
    Paybackpayback month 1
    Net time+$100,000
    Net money$0
    Net risk$0

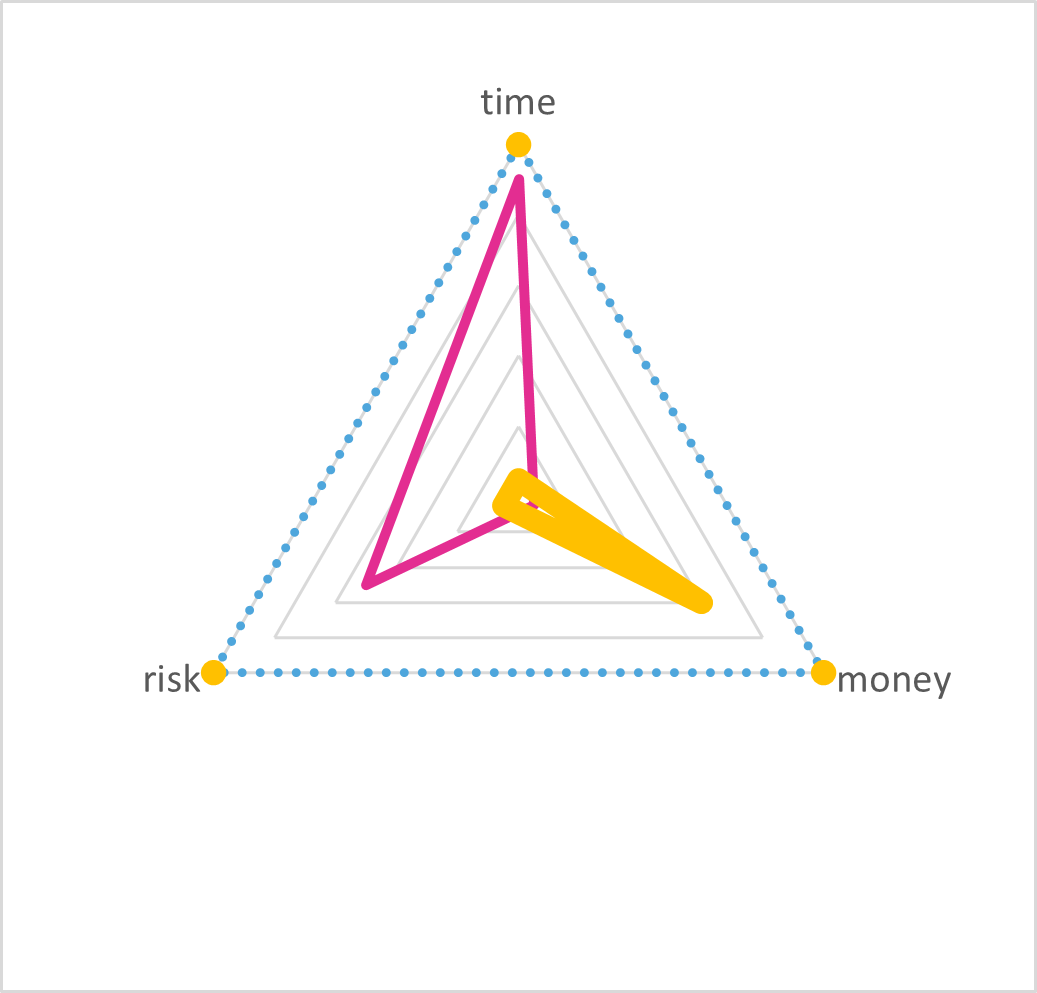

  3. Two vendors cut0.55×net −$29,000no payback within 12 monthsillustrative figuresGiven uptime −$52k (given up)time −$52krisk −$13k (given up)risk −$13k$65,000Gainedmoney +$36k (gained)money +$36k$36,000time −$52,000 · money +$36,000 · risk −$13,000
    Two vendors cut: the numbers behind the chart, over 12 months
    ItemPillarSideDollars
    Staff covering the gaps (illustrative)timegiven up$52,000
    Added risk exposure (illustrative)riskgiven up$13,000
    Vendor savings (illustrative)moneygained$36,000
    Multiple0.55×
    Gained$36,000
    Given up$65,000
    Net−$29,000
    Paybackno payback within 12 months
    Net time−$52,000
    Net money+$36,000
    Net risk−$13,000
Ranked by multiple. Each row is drawn to its own scale. Rows marked "illustrative figures" use values chosen for the example, not recalled.

The first version of this page scored the same three choices +257%, +200% and -45%. A negative score means it costs more than it returns. The inputs behind those scores weren’t recorded. The ranking above tells the same story with the current model.

Poor choice: removing two vendors

Before we used TRM to think through cuts, we eliminated two vendors. That moved cost in the right direction, but it cost more than it gained.

Benefit. We hit the goal of lowering vendor costs.

Cost. The company was exposed to more risk, and employees now had to cover gaps the software used to fill. That is time.

That tradeoff can make sense. But the analyses of other options showed we didn’t need to take on that risk and time. (I can’t be specific, for obvious risk reasons.)

Good choice: removing the UAT environment

In engineering we ran four environments. One, UAT (user acceptance testing), was meant to be an identical copy of production, down to the load balancing and scaling policies. We removed it entirely.

Benefit. It was one of our biggest cost savings (sorry, AWS). It also saved time: developers no longer had to deploy code to one more environment and test it all over again.

Cost. No team was using it for its intended purpose. It wasn’t catching anything the lower environments missed, so it no longer reduced the risk of a bad deployment. It might in the future, and that should be re-evaluated.

Automation: data-store provisioning

It wasn’t always about cost. Sometimes work that made big improvements elsewhere made more sense. A process for provisioning data stores slowed down both the product teams and the data team. That is time. What if we automated it?

Benefit. Capacity on the data team and the product teams went up dramatically. Conveniently, it also cut vendor costs, by moving to cheaper infrastructure.

Cost. If automating it were easy, we’d have done it sooner. Interestingly, the process existed to reduce risk. Reframing the problem in terms of value made automating it a clear winner.
